Al Faris completes power plant work

14 April 2021

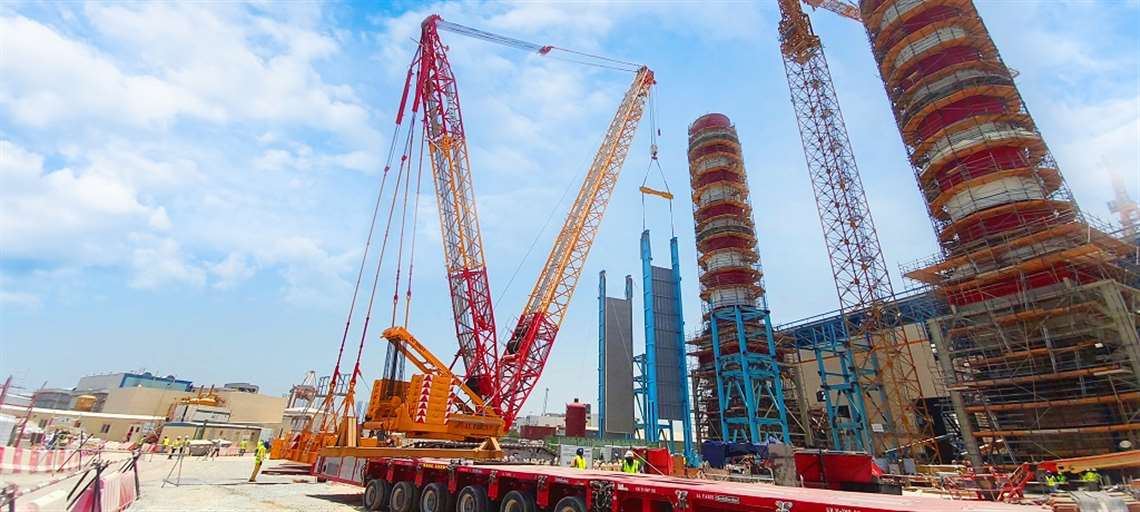

The Demag CC 3800-1 lifted 16 heat recovery steam generators, weighing up to 80 t, to a heigh of just under 60 m

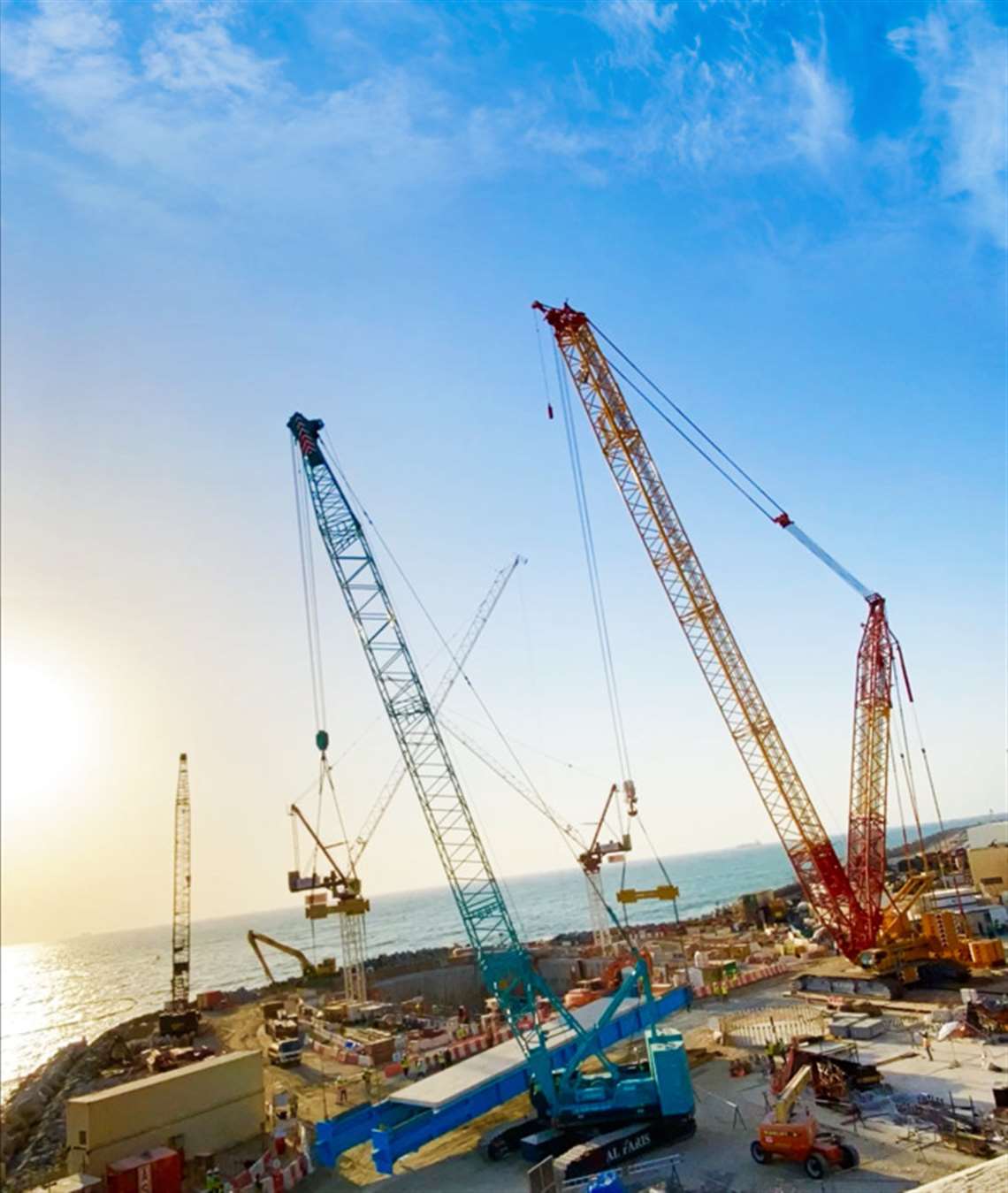

Dubai, United Arab Emirates-headquartered crane and transport specialist Al Faris has completed six months of work at a power station in the UAE. The work consisted of transporting and setting up various power plant components, including condensers, boilers, HRSG modules, generators, and tanks. For this Al Faris used a range of special-purpose vehicles including hydraulic trailers and various all-terrain and crawler cranes.

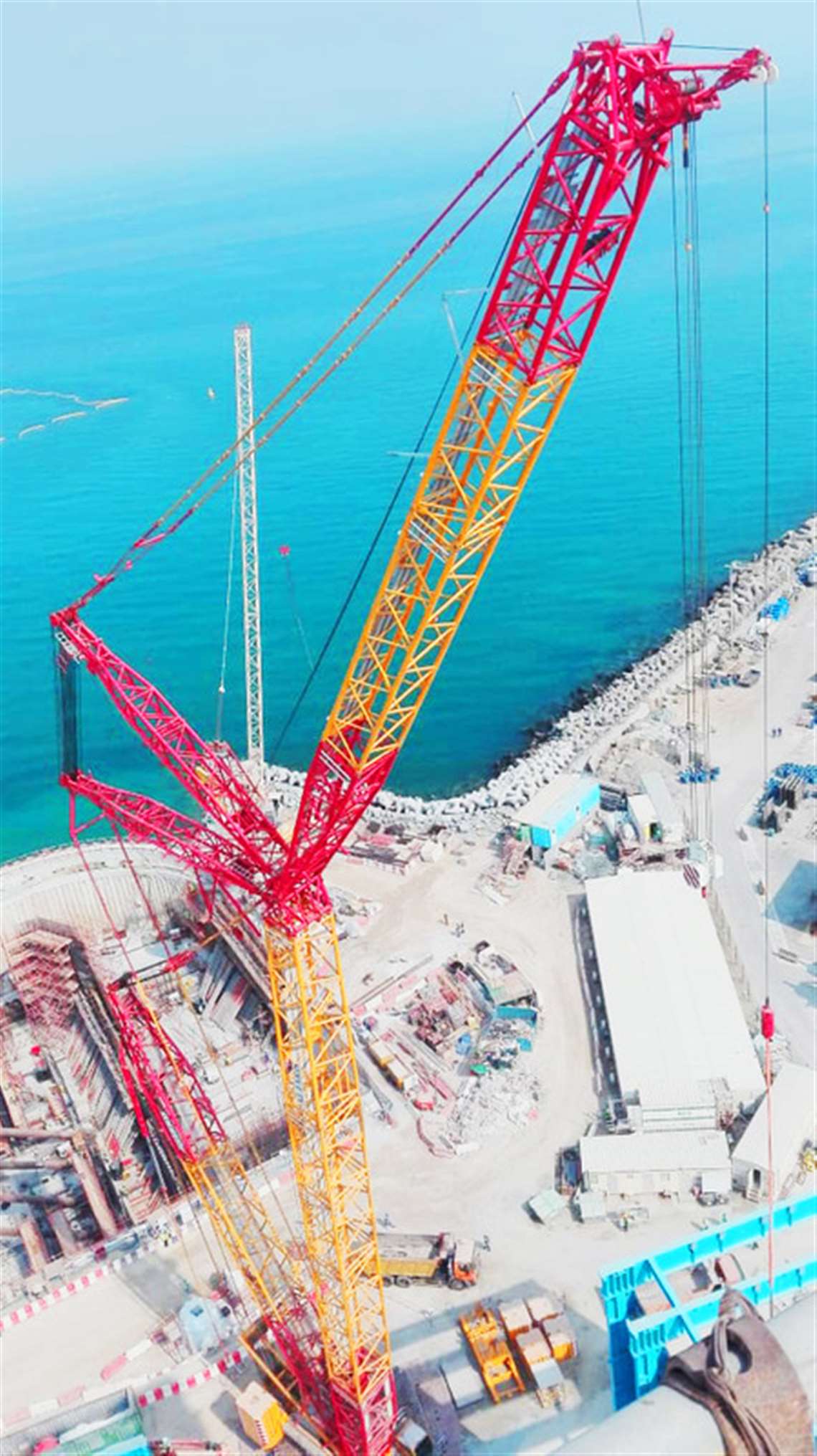

The largest crane on site was its 650 tonne class Demag CC 3800-1 lattice boom crawler crane which was used to install 16 double-wall heat recovery steam generators as part of an expansion of the power station. They will be used to recover the gas power plant’s waste heat and improve its efficiency.

The setup of the Demag CC 3800-1 took a team, comprising a crane operator, a supervisor, and five assembly technicians, 20 hours. It was set up with an SSL resp. SWSL configuration. Due to the SSL configuration and the limited space available, however, the crane’s 66-metre-long boom had to be assembled at height rather than on the ground.

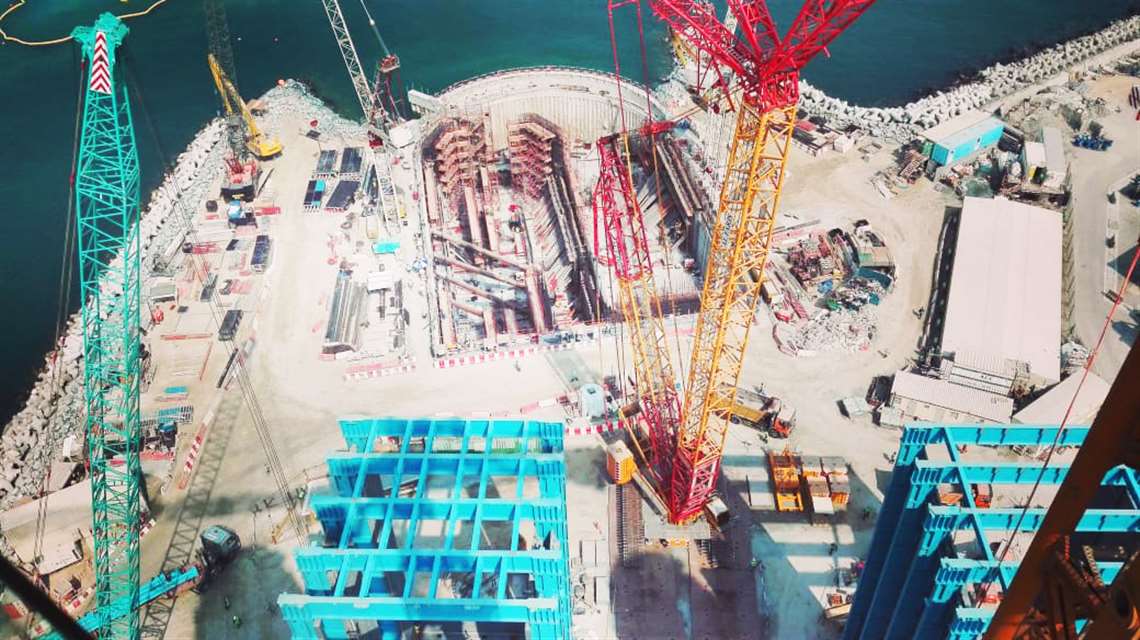

The 16 steam generators that the Demag CC 3800-1 lifted were 28 m in length and weighed up to 80 tonnes. They were lifted to a height of just under 60 m at a radius of 40 m. To do this, the Al Faris team used an SWSL configuration with a 48 m main boom, a 36 m fly jib, and a Superlift counterweight of 165 tonnes with a radius of 11 m.

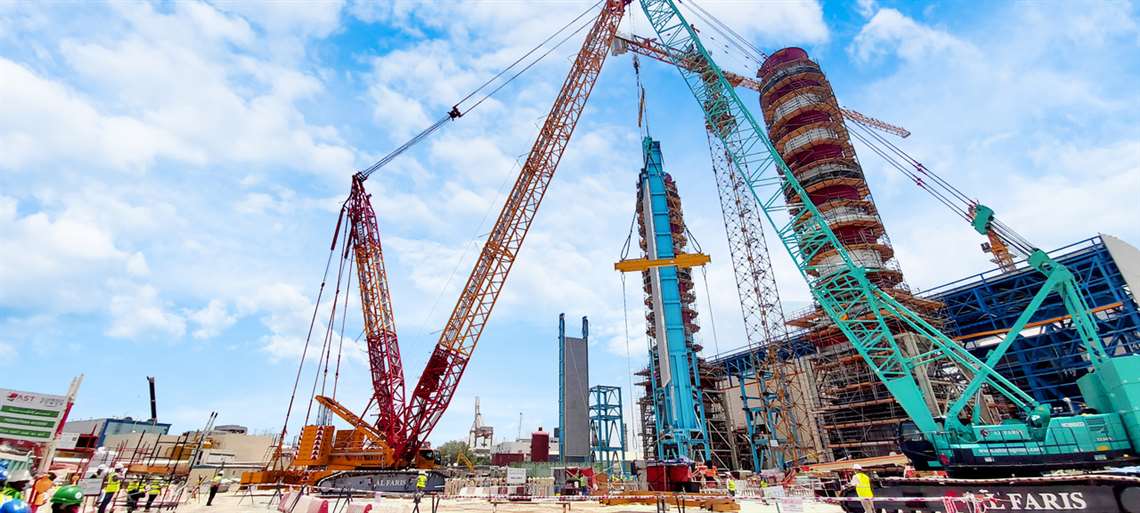

For these lifts the Demag CC 3800-1 was assisted by a 250 tonne crawler crane from Al Faris’s fleet which picked up each heat recovery steam generator from one end so that the CC 3800-1 could bring it to a vertical position. After this the 250-tonne crane let the CC 3800-1 take the full load. The CC 3800-1 then moved each generator into position.

It took the Demag CC 3800-1 took about two months to complete these 16 lifts, plus additional lifts, with its SWSL configuration.

“The biggest challenge was the tight space conditions during setup, conversion, and disassembly,” said Hilary Pinto, founder of Al Faris and its managing director. “Handling the long boom components really demanded a great deal of our team but they were able to take care of that smoothly and not in small part thanks to the crane’s ease of assembly.”

Latest News
Images | Volvo CE crowns winner of machinery skills contest
2025 Volvo CE Operators Club Final marked first-ever participation of graduates from Volvo’s Iron Women programme
Contractor named on £70 million decommissioning contract
Costain confirmed as principal contractor for nuclear project
Metso retains Metals & Chemical Processing business
Parts of the unit to also be adjusted to support growth
CONNECT WITH THE TEAM
Lewis Tyler Editor Tel: +44(0) 7566 799988 E-mail: [email protected]
Peter Collinson International Sales Manager Tel: +44 (0) 1892 786220 E-mail: [email protected]
CONNECT WITH SOCIAL MEDIA

If You’re Not Here, You’re Catching Up.

Experts from every continent come together at The World Demolition Summit to share how they’re solving the challenges you’ll face tomorrow. Learn from failures, near-misses, and creative recoveries that shaped some of the industry’s biggest projects.

📅 3-5 November 2025
📍 Nashville, TN
🎟️ Conference, Networking & Awards Dinner

Count me in!
